They can build 4 out of every 5 ordered so not that bad really.Looking like us with a SAS package are on the back burner yet again.
It is to return for 2024. Info direct from Ford.Bunch of uncoordinated office rats are trying to kill the manual again.

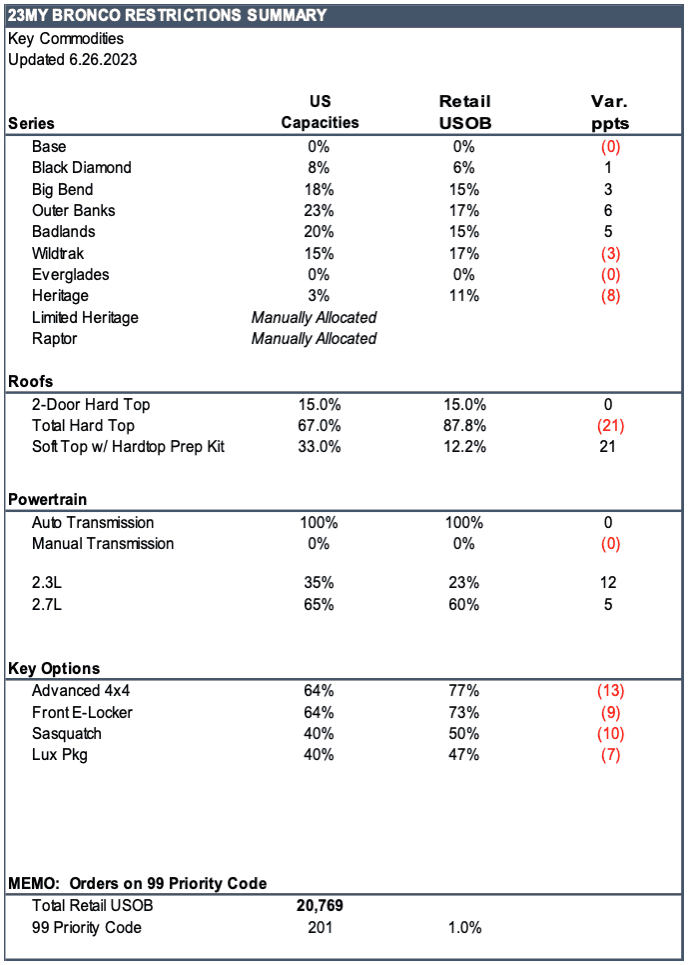

It’s been posted and at about 15% capacity for quite some time. Orders appear to be more in line now with what they can build. Had been in the 25% range.Finally a breakdown of the 2 door top constraint percentage. I don't think I've seen that broken down before.
I have a hard time believing it's much of their fault. I imagine Webasto constructed them exactly how the rockstars sent the files for them to be made.Wow, hard tops are STILL constrained coming up on two years!? What the hell Webasto
looks like Lux, sas, electronic lockers, sas, but if already scheduled good to go or still delayed I wonder?Looking like us with a SAS package are on the back burner yet again.
So, what does it all mean
I would tend to agree, they seemed to have no problem with the Jeep tops.I have a hard time believing it's much of their fault. I imagine Webasto constructed them exactly how the rockstars sent the files for them to be made.
So, what does it all mean? X% of constraints on certain items, is this a % of items not available or a % of items available.
The US Capacities are the % they can build. The Retail USOB are the % of orders in with those commodities. Red means more orders in than can be built with that commodity. Hope this helps!So, what does it all mean? X% of constraints on certain items, is this a % of items not available or a % of items available.
